Learn about the new functionalities for Production Planning/Detailed Scheduling in SAP SCM 5.0 that help facilitate planners’ tasks.
Key Concept
Production Planning/Detailed Scheduling in SAP Advanced Planning and Optimization allows planners to create feasible short-term production plans and rough medium- and long-term plans. With the Production Planning aspect, planners create production plans across different production locations to fulfill orders according to customer specifications. Planners use the Detailed Scheduling aspect to deliver optimized order sequences that they can release for production.
Note
For an overview of the SAP SCM 5.0 release and information about enhancements to Demand Planning (DP), Supply Network Planning (SNP), and Capable-to-Match (CTM) in APO in this release, refer to my article, “
SAP SCM 5.0: What’s New in DP, SNP, and CTM.”
Setup Matrixes
Several PP/DS master data updates improve setup matrixes, which contain the setup duration (how long it takes to
set up a resource, such as a machine) and setup costs involved in changing a single resource from one setup status to
another. One update relates to transition times between different products or groups of products. In manufacturing,
transitions from A to B or changes from A to C, B to C, or B to A could result in different transition times. Cleaning
duration and machine preparation also could affect transition times. The updated setup matrixes provide more accurate
scheduling because you can consider dynamic transition times between two consecutive products.
In addition, SAP SCM 5.0 includes a new generation of complex setup matrixes that combine simpler matrixes and
characteristics. With this process, you maintain two simple matrixes and then combine them when you want a more complex
matrix. For example, using formulas, you could join a matrix for colors with a matrix for sizes to generate a more complex
matrix. This way you avoid having to spend a lot of time maintaining the complex matrix because you only have to maintain
the simple matrixes that make up the complex matrix.
If you integrate SAP APO with mySAP ERP 2005, you can integrate setup groups (characteristics of a given operation)
and setup keys (details about the setup status for a setup group), which was not possible before. This reduces maintenance
efforts and decreases errors because you maintain data only in one system.
Also with SAP SCM 5.0, you can now decide how resource usage influences setup duration. Until now, the system did
not take resource usage into account when it calculated setup duration. For example, say you have a work center with four
people and it usually takes two hours to set up the machine in the work center. One of the people becomes ill, so you are
left with just three people. With the old functionality, the system would have increased the setup duration to two-and-a-
half hours automatically. However, with the new functionality, you can manually set the system so that it maintains the
same setup duration of two hours.
PDS
The second PP/DS change refers to PDS, introduced with previous releases. PDS groups bill of materials (BOM)
information and routes it in a similar way to the production process model (PPM). Now you can maintain the APO information
in R/3 or mySAP ERP Central Component (ECC) before you send it to the APO system. That means you can maintain all of the
data in the R/3 or ECC system. In SAP SCM 5.0, follow menu path Logistics>Central Functions>Core Interface
APO> Integration Model>Change Transfer>PDS>Change PDS before you integrate PDS with R/3 or ECC to add

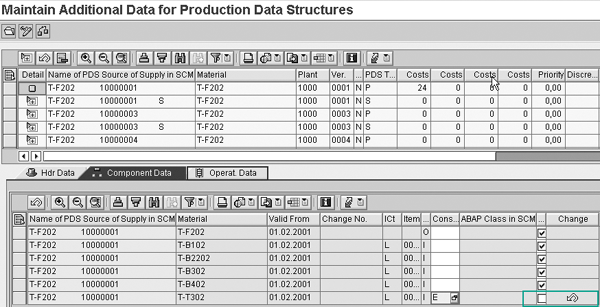

or change data in PDS (Figure 1).

Figure 1
New transaction for PDS maintenance
Planning and Scheduling Heuristics
Planning and scheduling heuristics are responsible for getting answers to planning scenarios, and they are
the heart of most PP/DS processes. Table 1 shows the number of PP/DS heuristics included with SAP SCM
5.0, compared with previous releases. SAP incorporated 12 new heuristics that provide new capabilities and enhanced many
of the old ones. Some examples of these algorithms, or problem-solving techniques, include material requirements planning
(MRP) execution, standard lots planning, scheduling of operations, bottom-up or bottom-down scheduling, and determining
critical paths. The new heuristics include new explosion, extended backward scheduling, and capacity push.
|
Table 1 |
Evolution of standard heuristics included in the APO and SCM
releases |
New Explosion
Follow menu path IMG>SCM>APO>Supply Chain Planning>PP/DS>Heuristics>Maintain

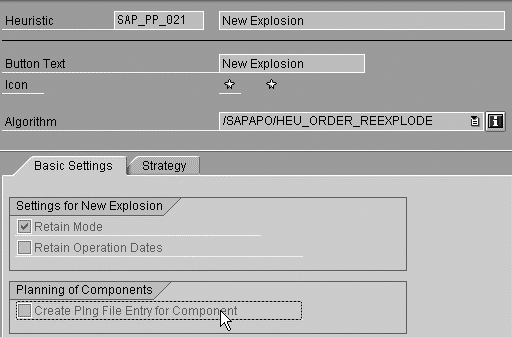

Heuristic (Figure 2). This heuristic introduces functionality that allows the planner to decide
if component changes that require a new BOM explosion should change or retain the operation dates (using the
Retain Mode flag) when you re-explode an order. For instance, when you change a component in the BOM, you
must re-explode the order so the system adds the new component to the order components. In the past, this change also
implied a rescheduling of the order operations, which could cause the system to lose any manual changes you made. You can
control this behavior with this new setting.

Figure 2
New Explosion heuristics
Extended Backward Scheduling
This heuristic provides an alternative to the optimizer tool when you want to obtain a finite result after
planning. It provides a feasible finite plan by performing a backward scheduling of operations. It starts to schedule
order operations on operation due dates and accounts for free capacity of resources, alternative resources, and order
priorities. For example, you can use it to analyze capacity problems after an infinite MRP. It’s not as complex as
the optimizer tool and allows the planner to check if the resources are overloaded. Although the solution is not optimal
for scheduling, it can give the planner a quick view of the current capacity situation with a first finite solution. Short-
term scheduling still is required because extended backward scheduling cannot provide a well-sequenced solution.
Capacity Push
In many cases after scheduling, free time slots exist in the resource capacity, which provide an undesired
low-usage level, especially in consumer product companies. You can use the new capacity push heuristic to fill the
available gaps to improve resource usage. For example, some companies require that a resource work 100% of the available
time. You can use this heuristic to fill the gaps when the resource has a workload of less than 100%. This heuristic
covers the gaps either by creating new production orders or changing production order size by extending existing orders
forward or backward (Figure 3).

Figure 3
Heuristic setting
Resource Planning Table
The new resource planning table offers an alternative to the Detailed Scheduling Planning Board (DS
Planning Board), a graphical scheduling tool in PP/DS based on a Gantt diagram for resource planning. With the resource
planning table, you work with buckets (days) in a spreadsheet interface. Access this new tool via menu path
APO > Production Planning > Interactive Production Planning > Detailed Scheduling > Resource Planning
Table. In the resource planning table, the capacity planner can schedule operations based on the capacity-

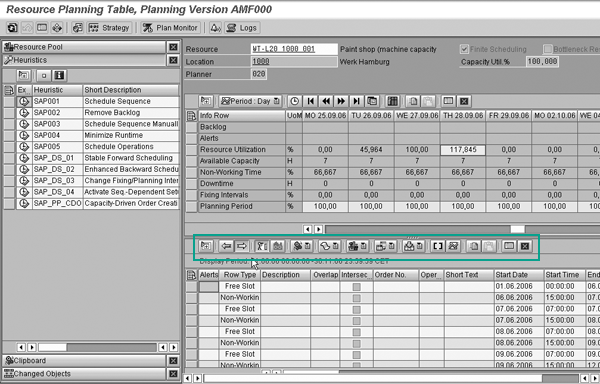

balancing information included in the Resource Planning Table screen (Figure 4).

Figure 4
New resource planning table
From the selection area on the left side of the screen, the planner can navigate a list of resources,
execute a scheduling heuristic, or check changed objects. The information area on the right side of the screen provides a
detailed view of the current capacity situation that shows the Resource Utilization and Available
Capacity as well as capacity discontinuations such as Fixing Intervals or
Downtime. Additionally, icons on the screen facilitate the navigation to other transactions. SAP also
added a similar resource pool sub-screen to the DS Planning Board.
Optimization Improvements
Optimization in PP/DS introduces several functionalities, such as order prioritization, compact scheduling
of order operations, and the explanation tool added to the available optimizer tool.
Order prioritization: With order priorization, you can give production orders higher
priority over planned orders. This is useful when you have a mix of both types of orders and you want to give temporary
priority to the production order to meet order requests. The planned order typically has lower priority during scheduling
because it is a planning object, whereas the production order is an approved document to start the production process.
Compact scheduling of order operations: In previous versions, optimization provided a
sufficient solution for the order operations along finite resources. However, the total lead time or make span (the
overall completion time for an order) determined by the rest of operations was not ideal. Compact scheduling reduces the
time intervals between the activities, which reduces the lead time and, implicitly, two other important business
parameters: storage cost and wait time.
Explanation tool: Traditionally, the optimizer tools have been compared to a “black
box,” where mathematical algorithms solve a complex problem sometimes with limited understanding of the final
solution. You start with a problem plus guiding parameters and then you get a solution. What happens when the algorithms
execute? That’s what the explanation tool tries to answer. When you click on the explanation icon
, the Explanation Log screen appears with information
about what occurs during the execution (Figure 5).
Note
The explanation tool exists for other APO optimizers, providing a way to check, understand, and then react to normal or abnormal results. Solutions provided by the SNP optimizer, deployment optimizer, or CTM engine make more sense with these explanations. For example, when you analyze an SNP log you could check the service level of a particular solution or determine why a delay happens.

Figure 5
New explanation tool for SCM optimizers. This is an example of a PP/DS optimizer.
For instance, the planner can refer to an explanation of an unexpected delay and react appropriately based
on this information. The Explanation Log screen provides an overview of the different parameters that the
optimizer tool considers. In Figure 5, you can see delayed resources or products by clicking on the corresponding tabs.
These tabs provide information about the results. Based on this information, planners can execute the optimizer tool with
new parameters if the result is unacceptable, or they can change the result manually.
Process Chains
With SAP SCM 5.0, SAP extends process chains to PP/DS. This provides more flexibility when a complex chain
of jobs is required. You can create parallel paths or decision points with OR and AND statements, in comparison to a
linear path with standard jobs A?B?C. Follow menu path APO>Production Planning>Automated
Production Planning and optimization>Maintain Process Chain to access the process chain functionality. As

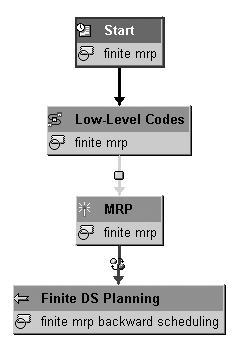

shown in Figure 6, this graphical tool defines steps.

Figure 6
Steps in a process chain definition
PP/DS also includes enhancements that affect other areas, such as block planning with a separate block
basis definition transaction, and easier block maintenance — two processes related mainly to the steel industry.
I’ll cover this and other enhancements related to specific industries in a future article.

Adolfo Menéndez Fernández
Adolfo Menéndez Fernández is the application architecture manager at Repsol in Madrid. Previously, he worked at SAP Consulting Spain as the logistics consulting manager. He studied at the University of Oviedo, where he earned an electronic engineering degree. He is a certified SAP consultant in supply and demand planning (SNP and DP), order fulfillment (Global Available-to-Promise), production planning and detailed scheduling (PP/DS), as well as procurement and materials management (MM). Adolfo has more than 10 years of SAP implementation experience in the consumer product goods, pharmaceutical, automotive, furniture, textile, chemical, oil & gas, and steel industries using SAP ERP logistic modules (including PP, MM, and sales and distribution [SD]) as well as SAP SCM (DP, SNP, and PP/DS). He is APICS certified in Production and Inventory Management (CPIM).
You may contact the author at asturiasadolfo@yahoo.com.
